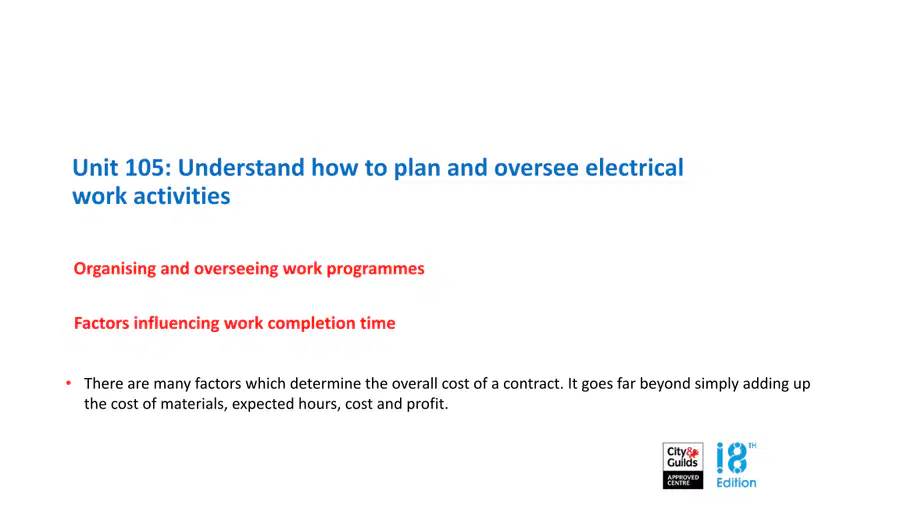

Planning and overseeing PTT 2

Planning and overseeing PTT 2

Assessment

Presentation

•

Construction

•

Vocational training

•

Practice Problem

•

Hard

Created by

Donna Hollett

FREE Resource

38 Slides • 29 Questions

1

media

2

Multiple Choice

What is the main focus of Unit 105?

1

Understanding electrical work activities

2

Planning electrical work

3

Overseeing electrical work activities

4

Organising work programmes

3

media

4

Multiple Choice

What are the factors that influence work completion time in electrical work activities?

1

Cost of materials

2

Expected hours

3

Profit margin

4

Weather conditions

5

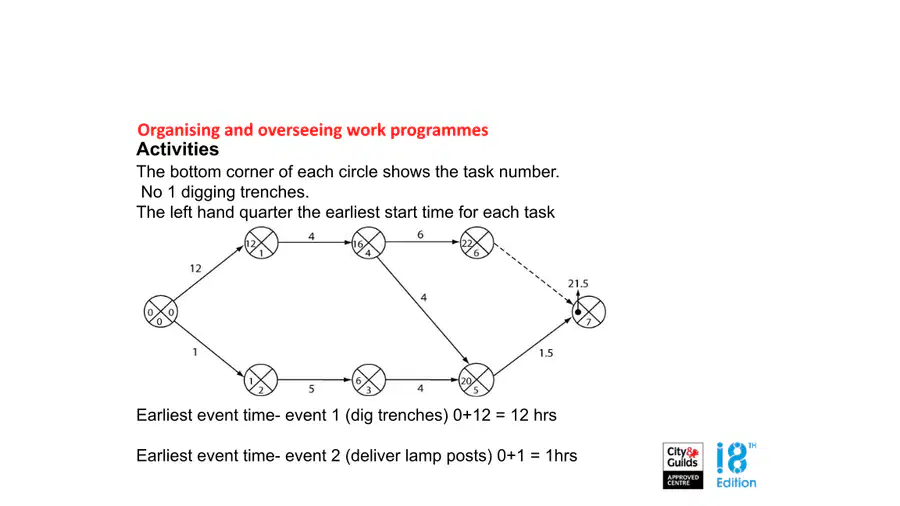

media

6

Multiple Choice

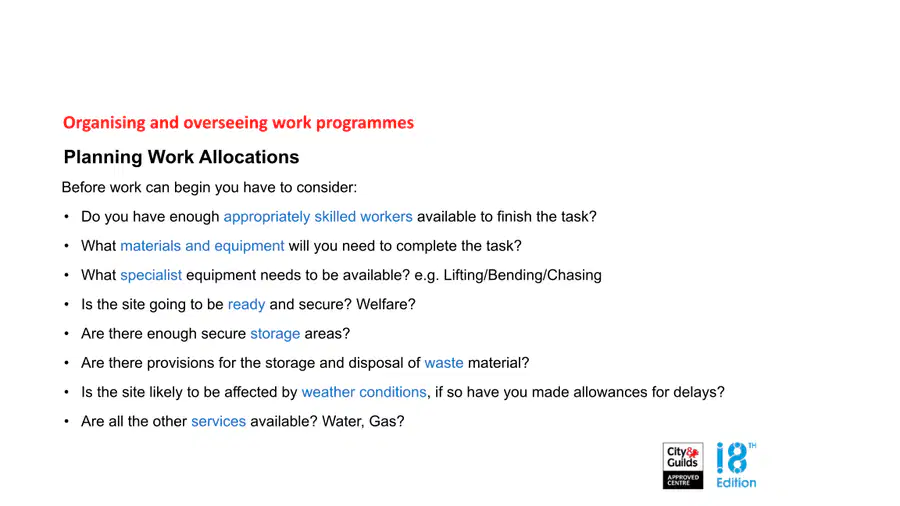

What factors should be considered before work can begin?

1

Availability of skilled workers

2

Weather conditions

3

Storage areas

4

All of the above

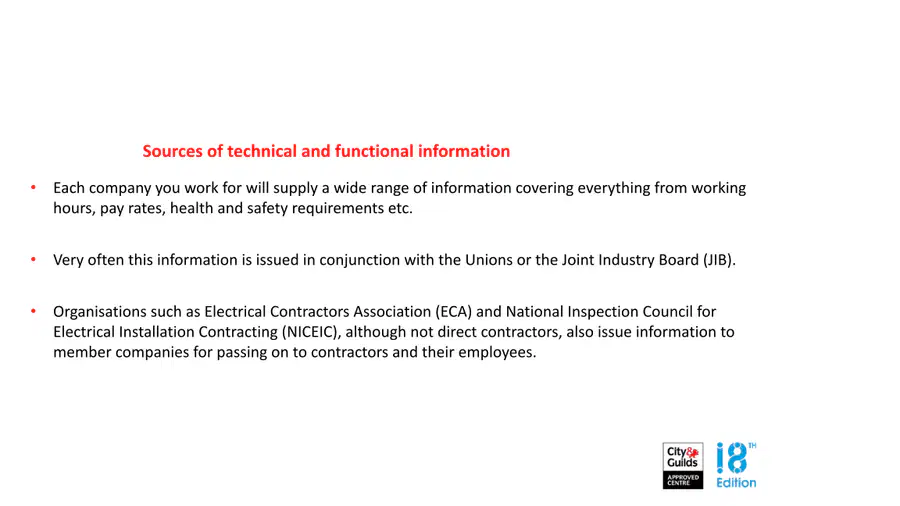

7

Multiple Choice

Which planning tool is used to allocate resources over a specific period?

1
Budgets
2

Schedules

3

Standards

4

Policies

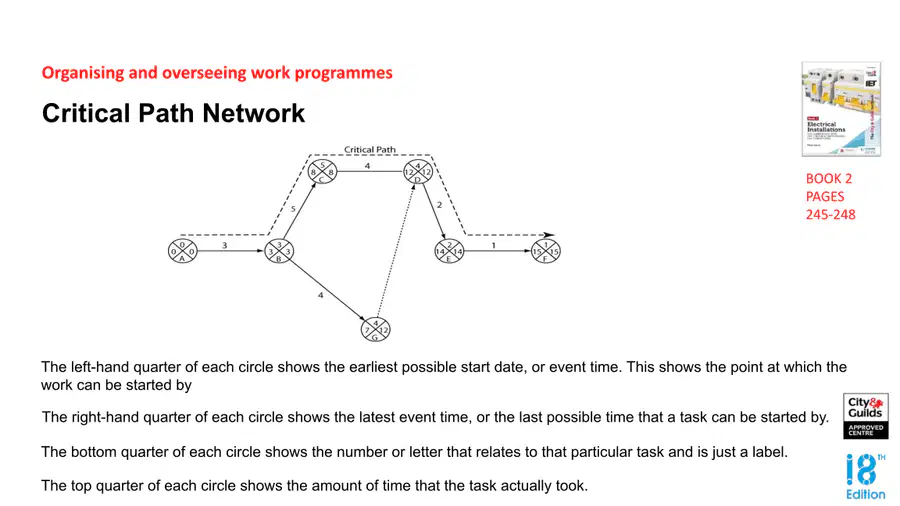

8

Multiple Choice

Which process puts more resources on the critical path?

1

crashing

2

fast tracking

3

leading

4

shortening

9

media

10

Multiple Choice

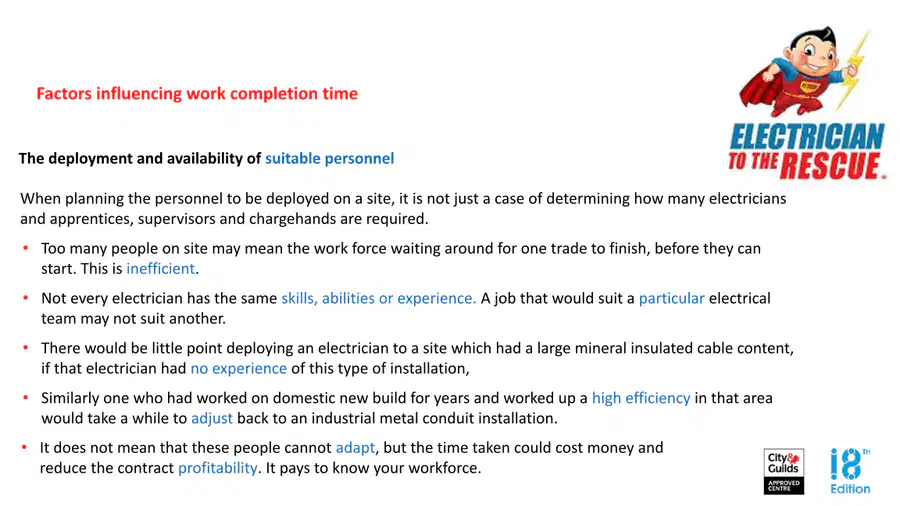

What factors influence the deployment and availability of suitable personnel on a work site?

1

Too many people on site

2

Different skills and abilities

3

Experience of electricians

4

All of the above

11

media

12

Multiple Choice

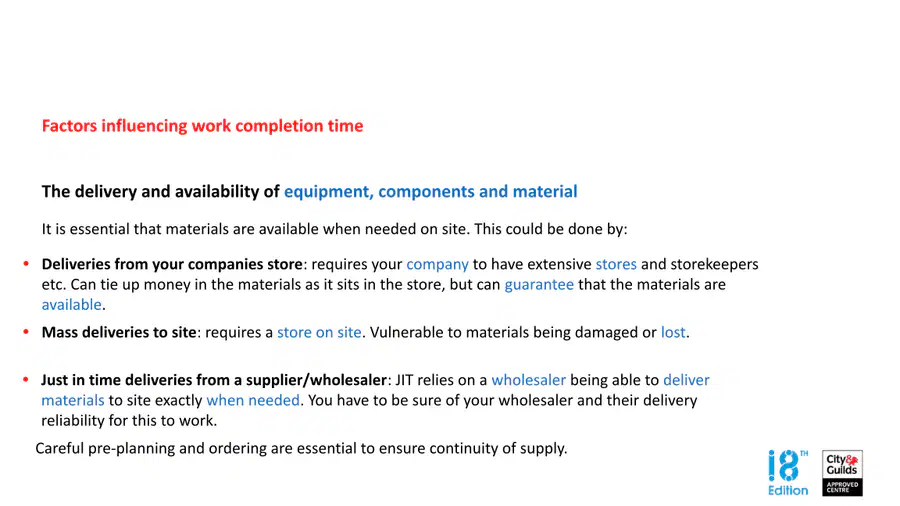

What are the methods to ensure the delivery and availability of equipment, components, and material on site?

1

Deliveries from your company's store

2

Mass deliveries to site

3

Just in time deliveries from a supplier/wholesaler

4

None of the above

13

media

14

Multiple Choice

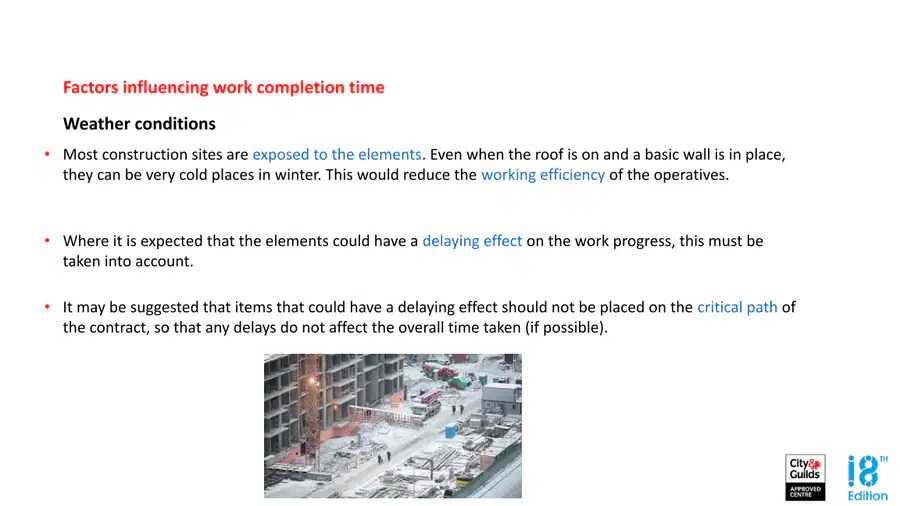

What factors can influence work completion time at construction sites due to weather conditions?

1

Exposure to elements

2

Availability of materials

3

Worker experience

4

Construction design

15

Multiple Choice

The project duration in a network can be determined by the largest value of which variable associated with the critical​ path?

1

Slack Time

2

Earliest Start Time

3

Earliest Finish Time

4

Activity Time

16

Multiple Choice

Which process puts more resources on the critical path?

1. Activity e with preceding activities STart, and duration of 8 days

2. Activity F with preceding activities E and duration of 4 days

3. Activity G with preceding activities E and duration of 10 days

4. Activity H with preceding activities F and G and duration of 2 days

5. Activity I with preceding activities H and duration of 2 days

6. Activity J with preceding activities H and duration of 2 days

7. Activity K with preceding activities H and duration of 3 daus

8. Activity L with preceding activities I, J, and K and duration of 2 days

9. Activity M with preceding activities L and duration of 1 day

1

19 days

2

25 days

3

26 days

4

27 days

17

Multiple Choice

Which of the following best describes critical path analysis?

1

It shows how a project can be completed with maximum labour resources

2

It shows how a project can be completed in the minimum time

3

It takes account for unforeseen events

4

It predicts the success of a project

18

Multiple Choice

Which best describes the critical path slack?

1

the activities on the critical path

2

the delay after the drywall is completed in a house to allow it to dry

3

the earliest a new HVAC system can be ordered from a manufacturer

4

the earliest a new HVAC system can be ordered from a manufacturer without delaying the project

19

media

20

Multiple Choice

What factors should be considered regarding work completion time due to other services?

1

Delays caused by other services

2

Internal service delays only

3

Public service delays only

4

No consideration needed

21

media

22

Multiple Choice

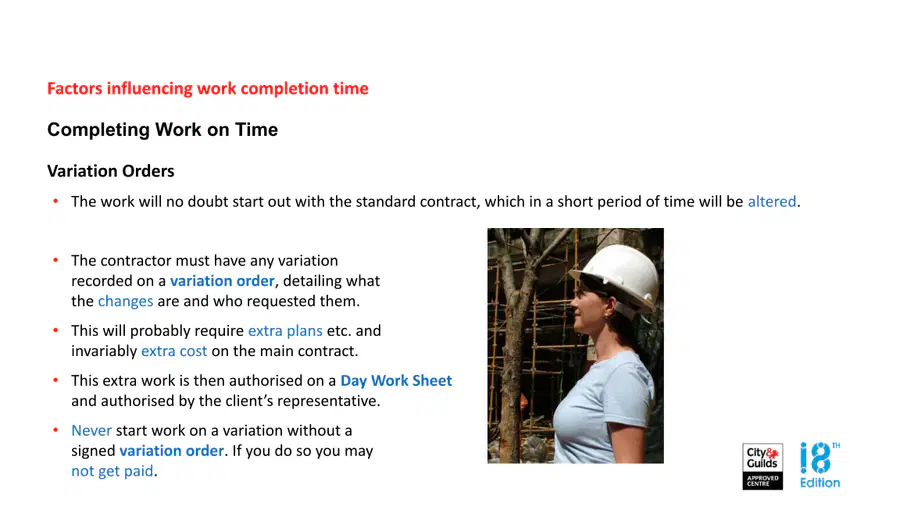

What is a variation order and why is it important in construction contracts?

1

A document detailing changes requested

2

A type of contract

3

A plan for extra work

4

A payment method

23

media

24

Multiple Choice

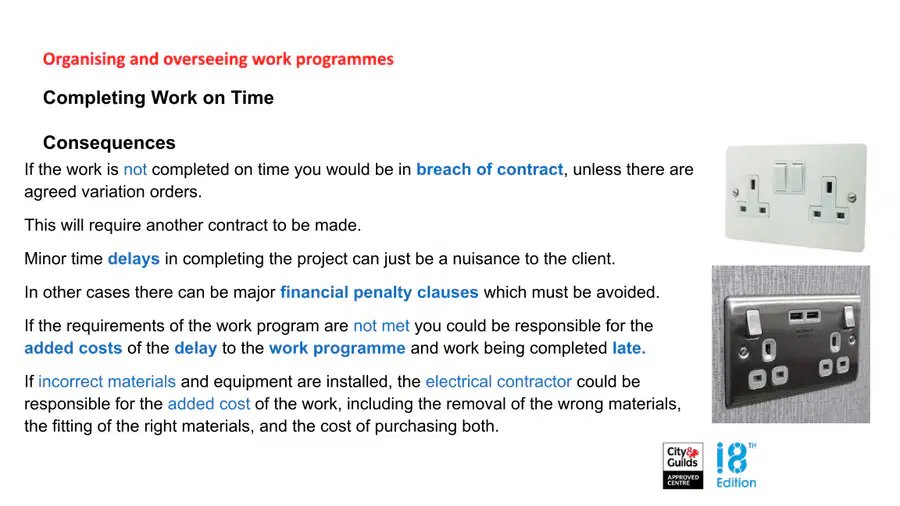

What is the consequence of a breach of contract?

1

Formation of a new contract

2

Legal remedies

3

Automatic termination

4

No consequence

25

media

26

Multiple Choice

What is the purpose of a Gantt chart in work planning?

1

To allocate resources

2

To track expenses

3

To schedule activities

4

To measure performance

27

media

28

Multiple Choice

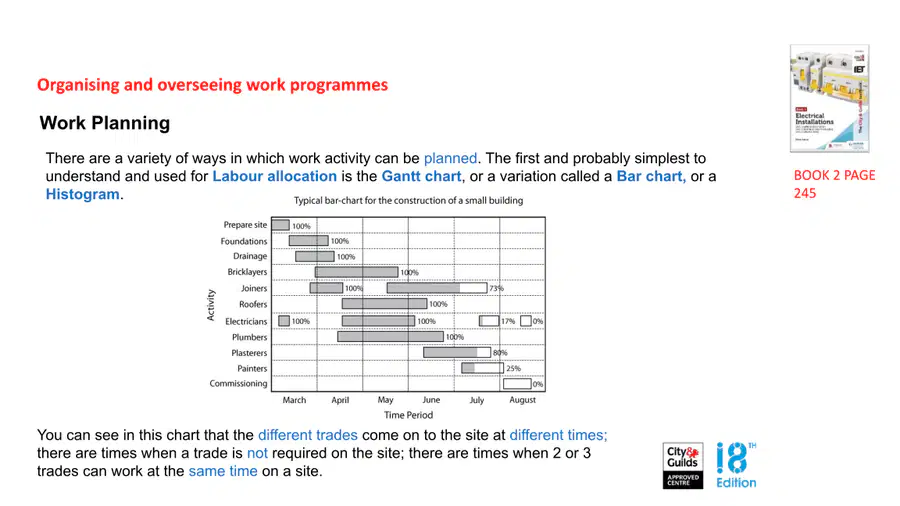

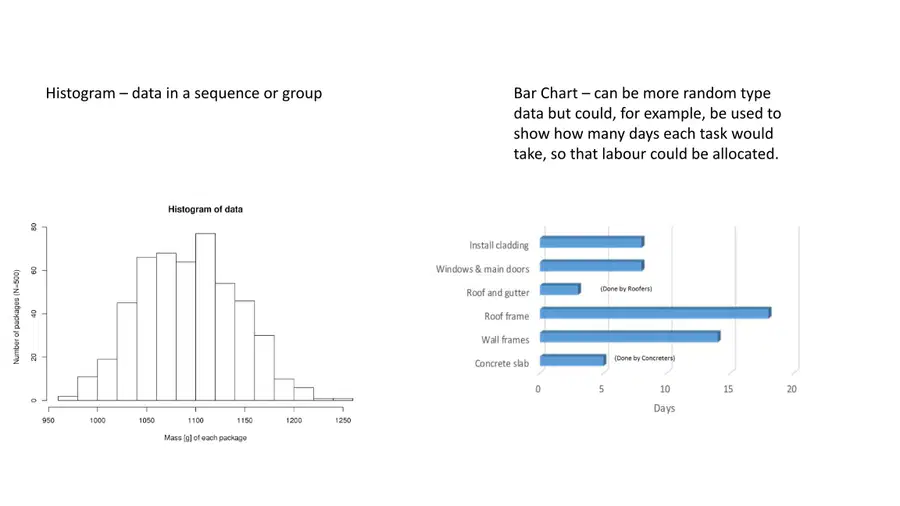

According to the bar chart, which task takes the longest time to complete?

1

Install cladding

2

Windows & main doors

3

Roof frame

4

Concrete slab

29

Multiple Choice

What does the histogram represent in terms of the mass of each package?

1

Number of packages

2

Average mass

3

Total mass

4

Standard deviation

30

media

31

Multiple Choice

What are the steps involved in installing the floodlighting in a car park?

1

Dig trenches

2

Deliver lampposts

3

Fix lampposts

4

Inspect and test

32

media

33

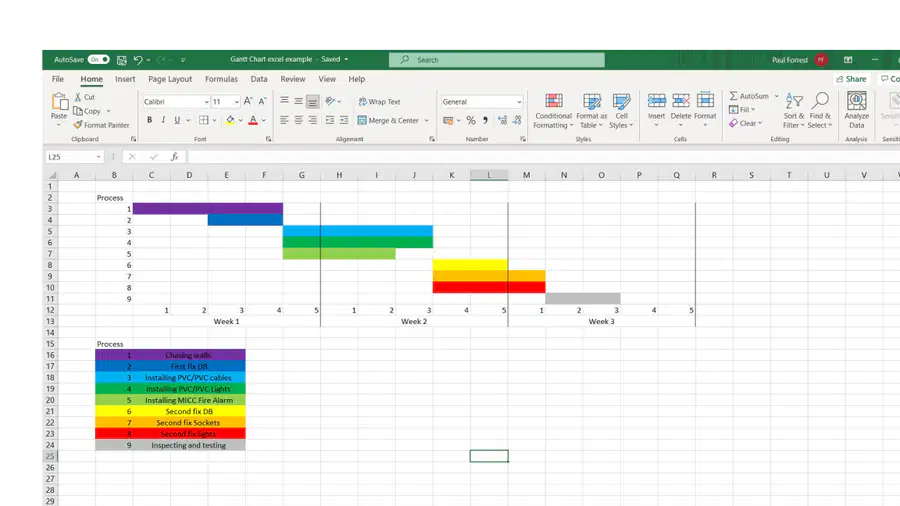

Multiple Choice

What is the total estimated time required to complete all tasks listed in the Gantt chart?

1

30 hours

2

28.5 hours

3

25 hours

4

20 hours

34

Multiple Choice

In an environment where the planned activities have been accomplished​ previously, there are several ways of getting time estimates. Which of the following is the least​ useful?

1

Learning curve models

2

Statistical methods

3

Random Number Generator

4

Prior Experiences

35

media

36

Multiple Choice

What is the significance of the start and end dates in a Gantt chart?

1

They indicate the duration of the project

2

They show when the team is on holiday

3

They are used for color coding

4

They determine the complexity of the project

37

media

38

Multiple Choice

What are the stages involved in Critical Path Network planning?

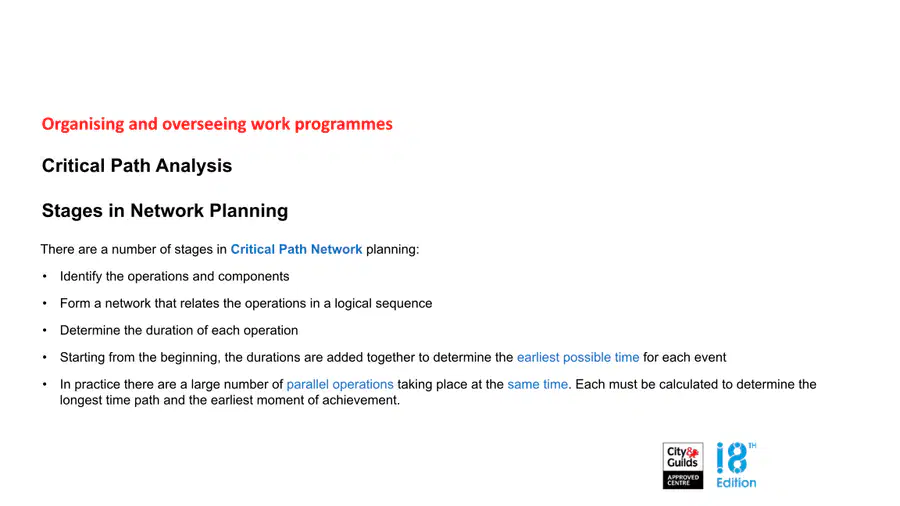

1

Identify the operations and components

2

Determine the duration of each operation

3

Form a network that relates the operations in a logical sequence

4

Calculate the total cost of the project

39

media

40

Multiple Choice

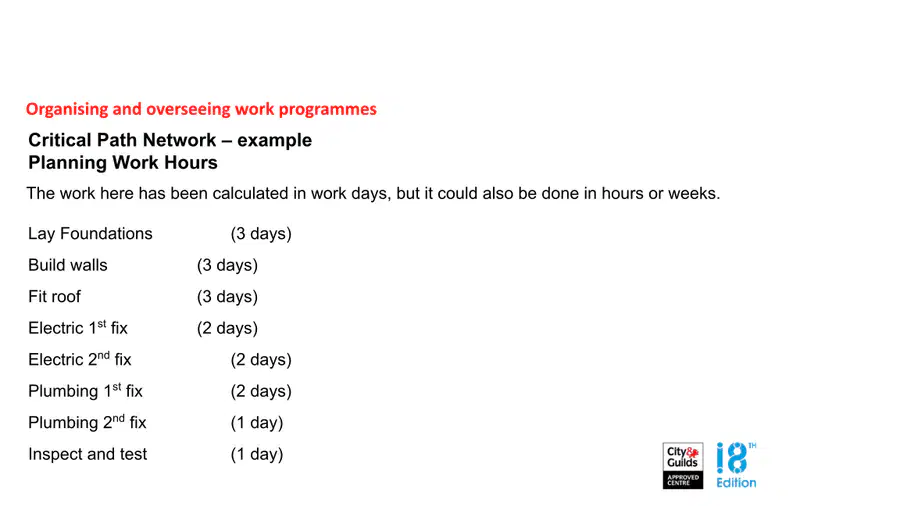

What is the total number of days required to complete the following tasks: Lay Foundations, Build walls, Fit roof, Electric 1st fix, Electric 2nd fix, Plumbing 1st fix, Plumbing 2nd fix, and Inspect and test?

1

12 days

2

14 days

3

15 days

4

10 days

41

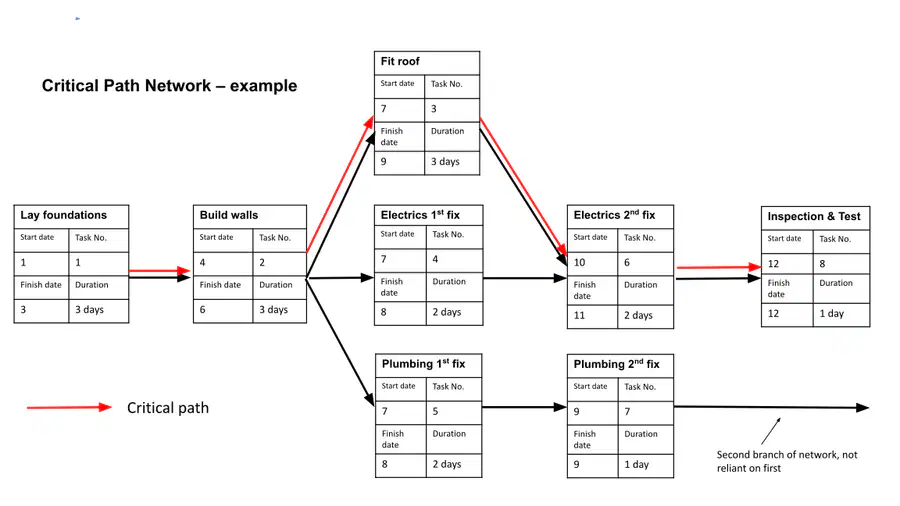

media

42

media

43

media

44

media

45

Multiple Choice

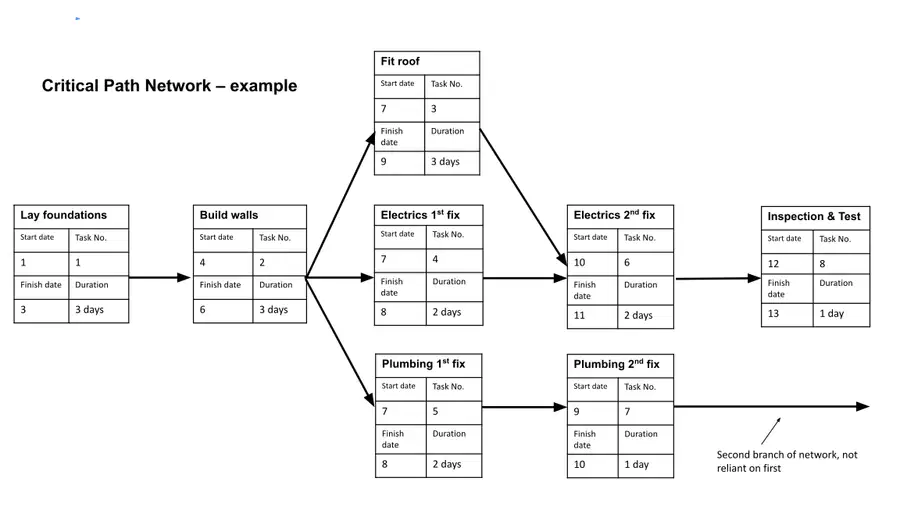

What is the critical path in project management?

1

The shortest path of events

2

The path that takes the longest time

3

The path with the least resources

4

The path with the most tasks

46

media

47

Multiple Choice

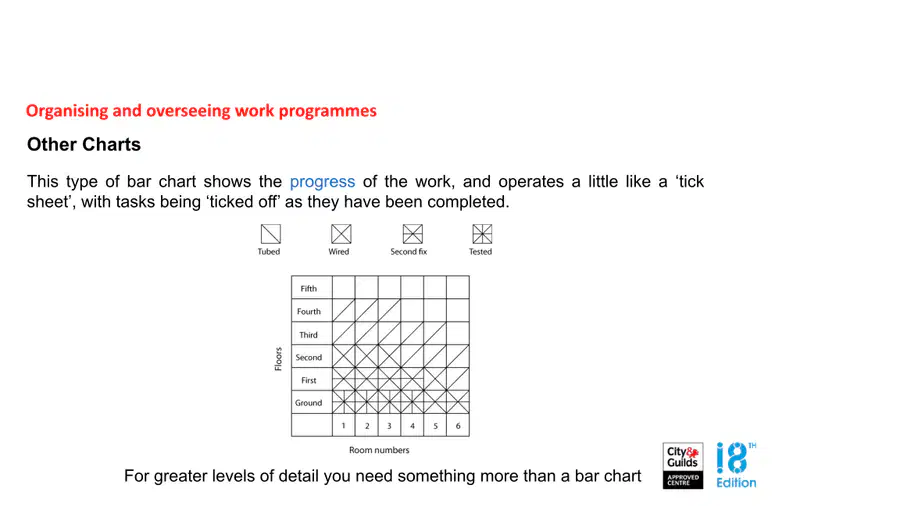

What does the bar chart represent in terms of work progress?

1

Tasks completed

2

Tasks pending

3

Tasks in progress

4

Tasks not started

48

media

49

Multiple Choice

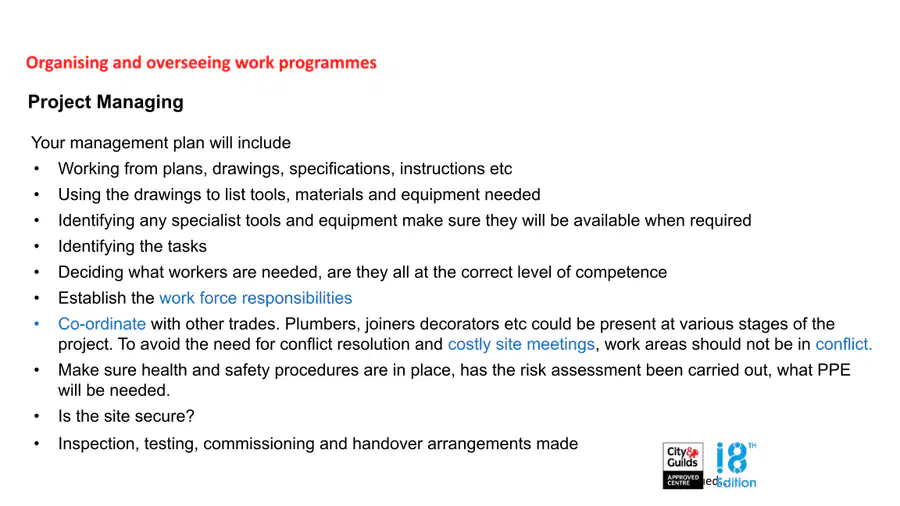

What should your management plan include when overseeing work programmes?

1

Working from plans and specifications

2

Ignoring health and safety procedures

3

Not coordinating with other trades

4

Avoiding conflict resolution

50

media

51

media

52

Multiple Choice

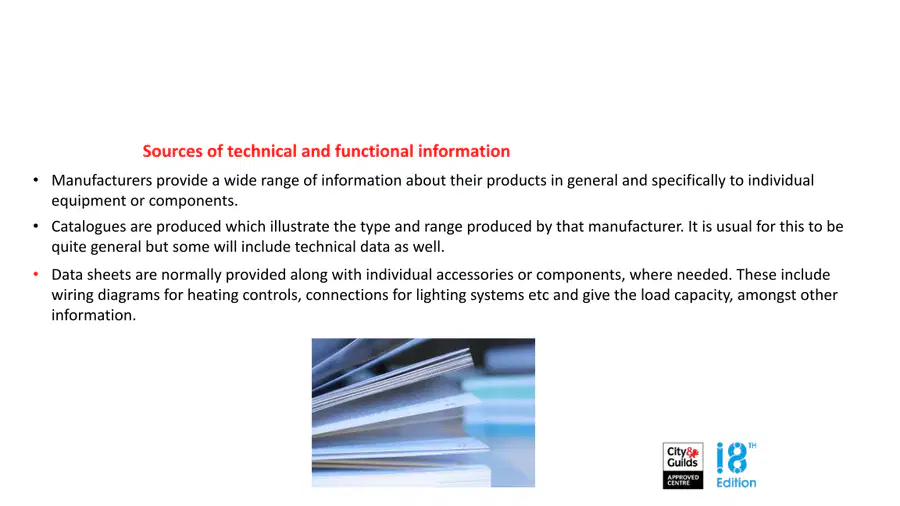

What are the sources of technical and functional information provided by manufacturers?

1

Catalogues

2

Data sheets

3

User manuals

4

Product reviews

53

media

54

Multiple Choice

What types of information do companies supply to their employees?

1

Working hours

2

Health and safety requirements

3

Pay rates

4

All of the above

55

media

56

media

57

media

58

media

59

media

60

media

61

media

62

media

63

media

64

media

65

media

66

media

67

media
pattern-tertiary
media

Show answer

Auto Play

Slide 1 / 67

SLIDE
